Skip to content

Prefabricated steel bridges

The Crossing,
Engineered.

Prefabricated steel bridges designed for faster installation, serious loads, and decades of service. Forty two standard models across four families, plus custom work when the crossing does not fit one.

Or call 903-224-9262 and describe the crossing.

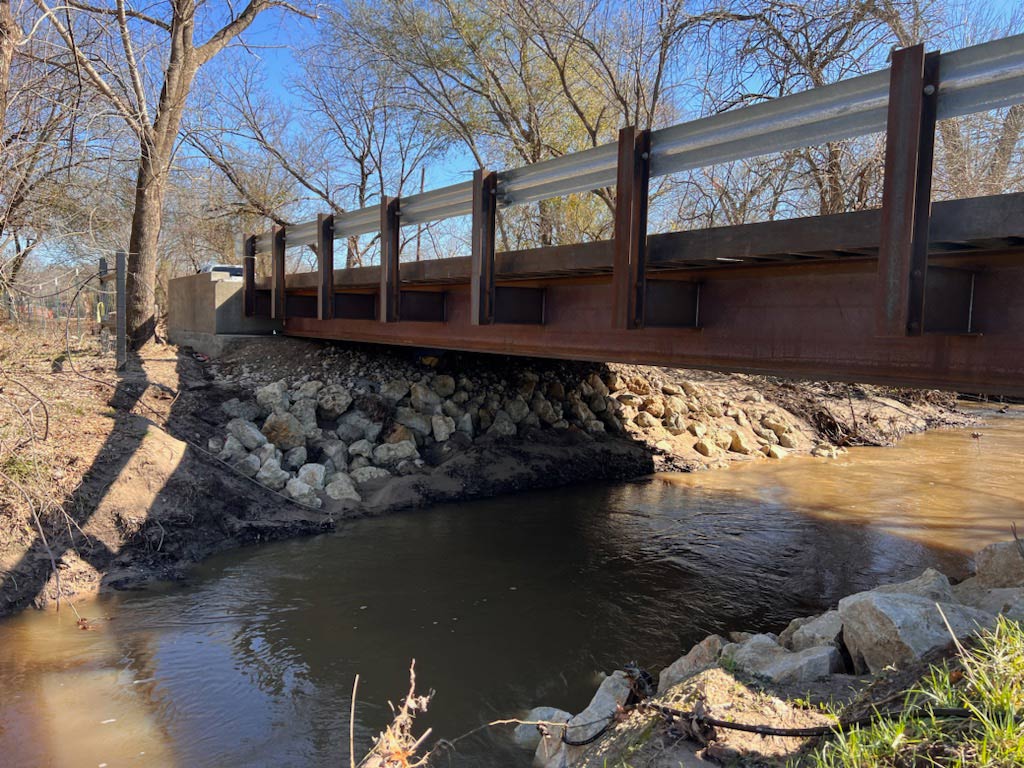

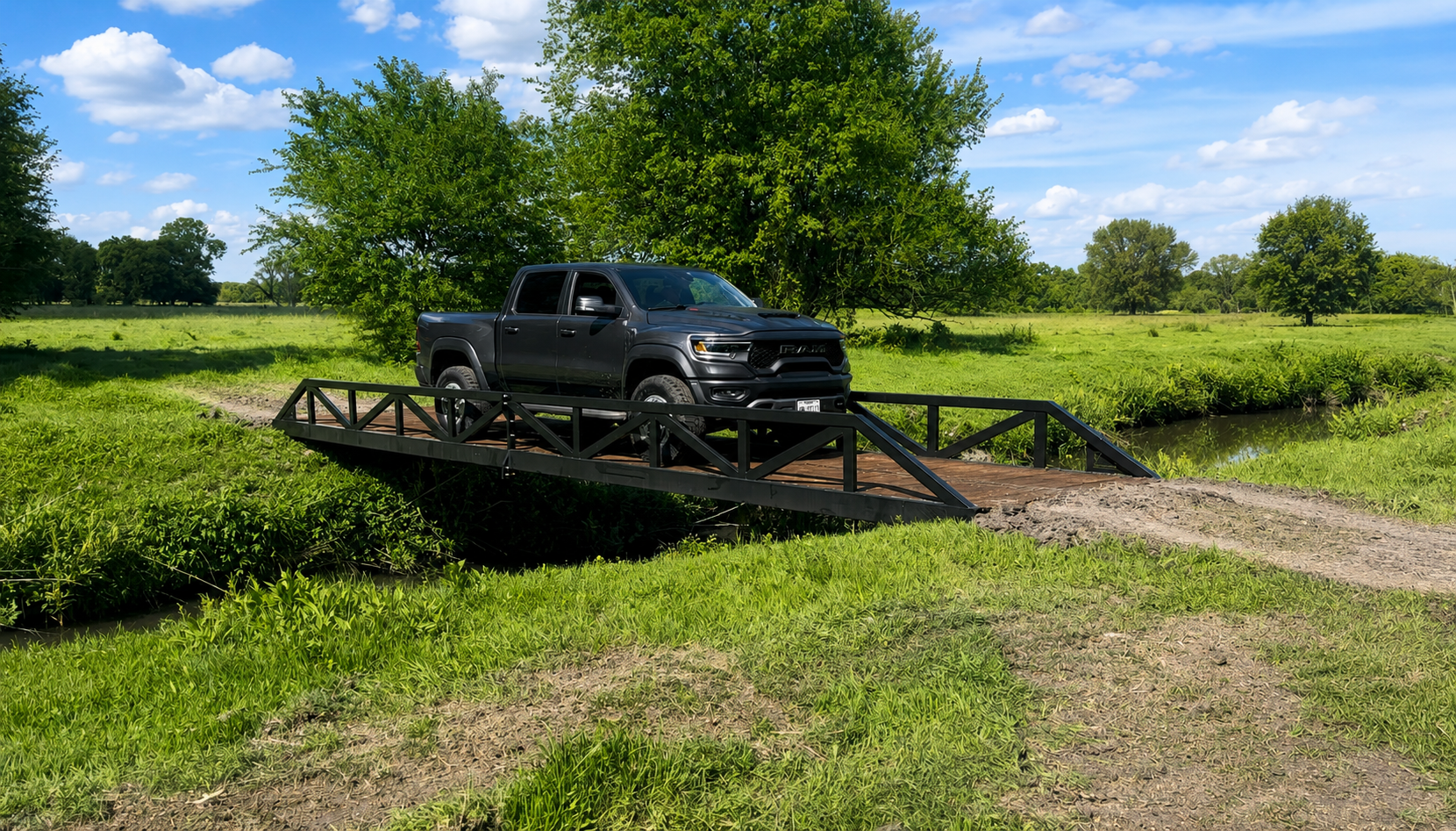

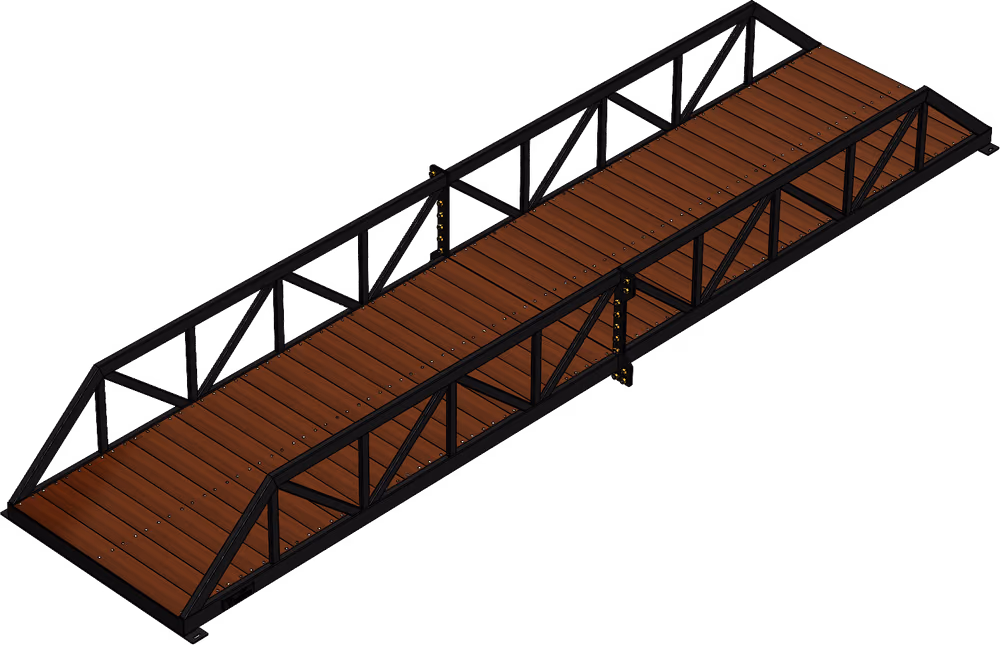

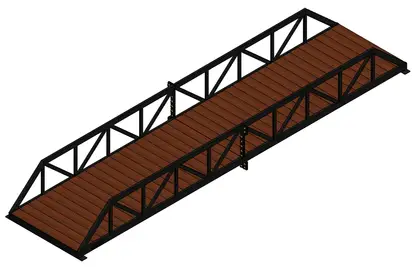

An eight foot by forty foot utility truss bridge with a forty two inch truss and timber deck, shown in three-quarter view.
Bridge
Lighting

Still image of the utility truss, 8 ft x 40 ft, 42 in truss.

Model shown
Utility Truss, 8 ft x 40 ft, 42 in truss
Span
40 ft
Deck width
8 ft
Truss depth
42 in
Finish shown
Powder coat black
Lighting
Studio
Origin
Made in USA
Models
42
Families
4
Spans
20 to 72ft
Design life
65years

How it holds

Engineered once,
fabricated under a roof.

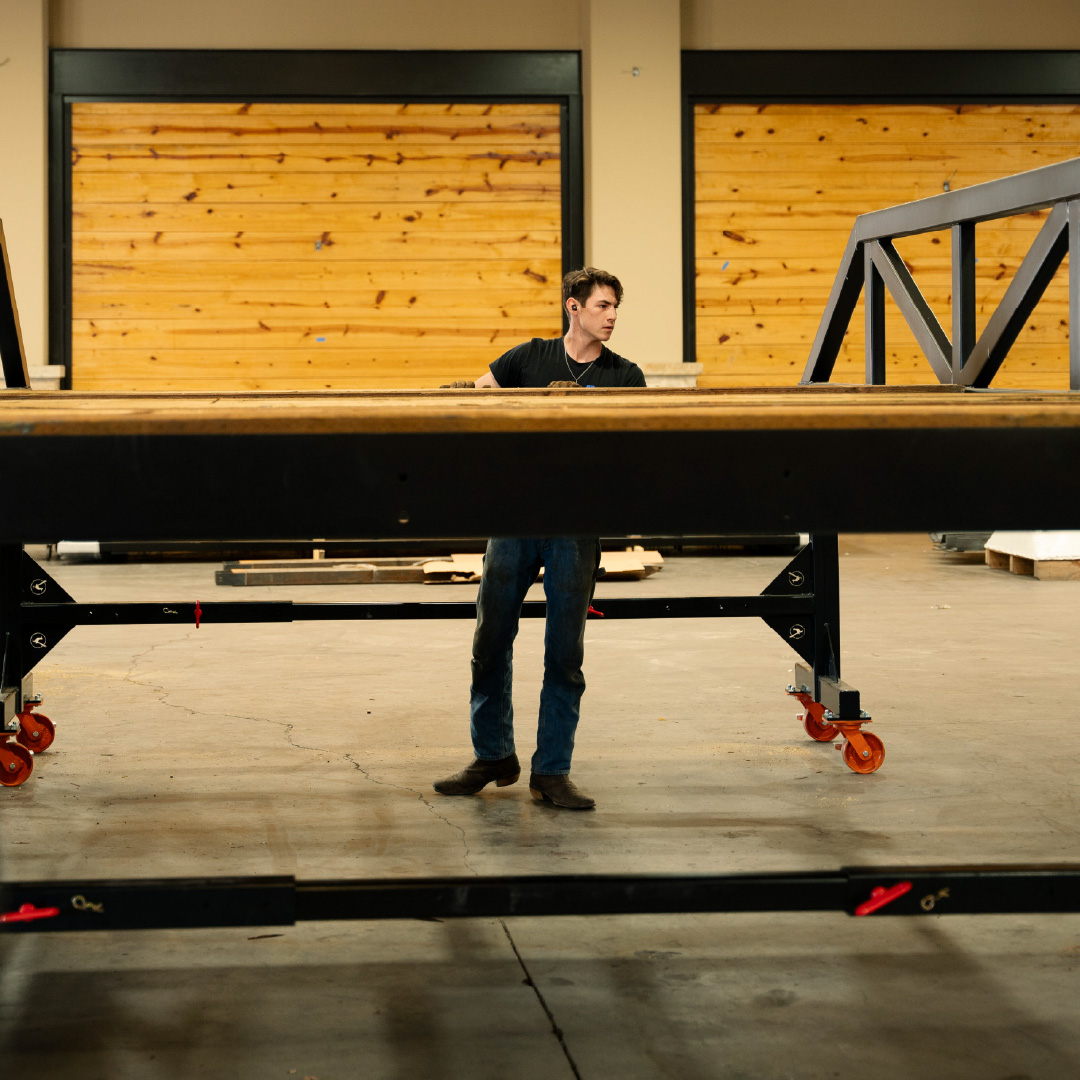

A prefabricated bridge is not a shortcut. The structure is designed for your loading and your site, then built on a shop floor with the welds inspected before anything ships. What arrives is finished.

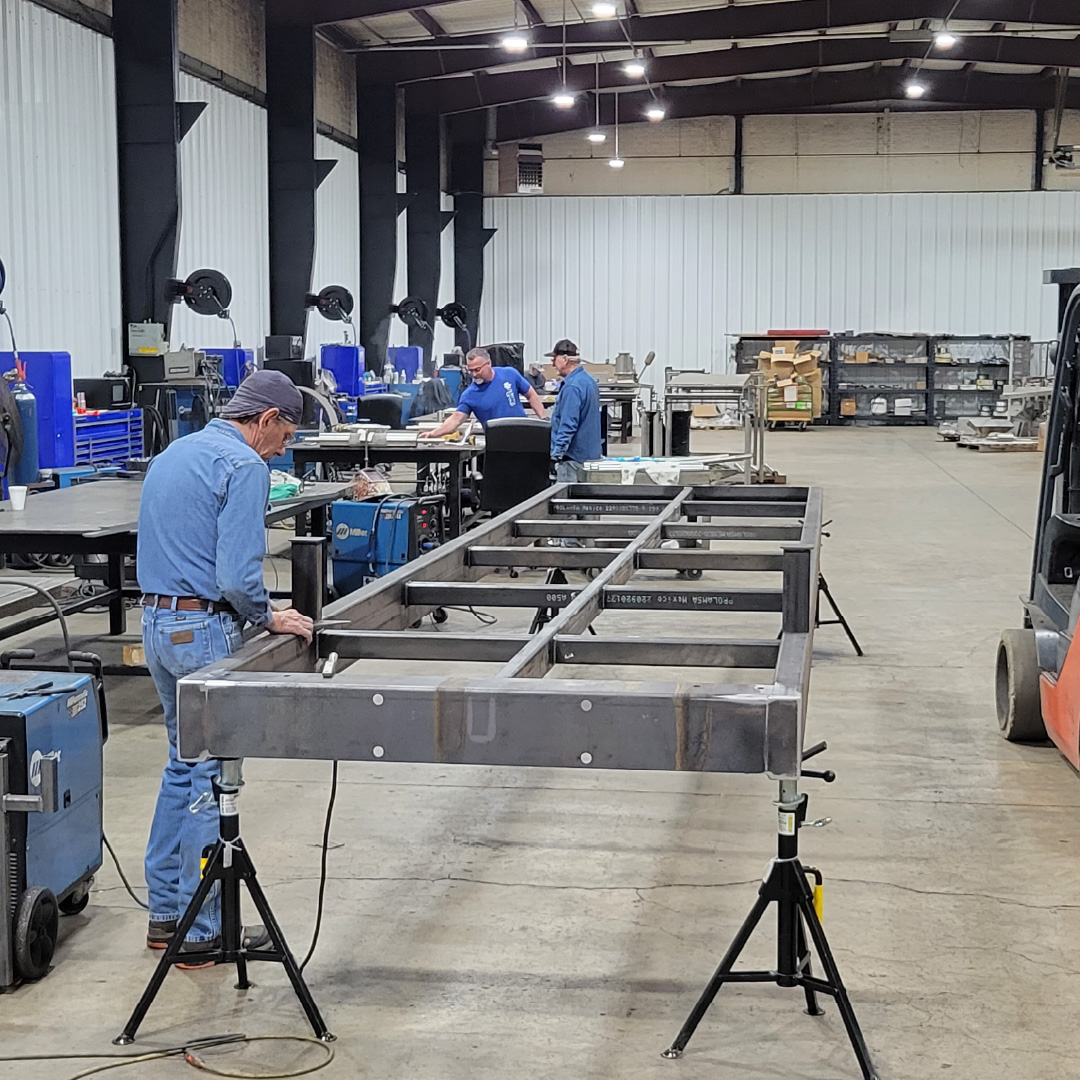

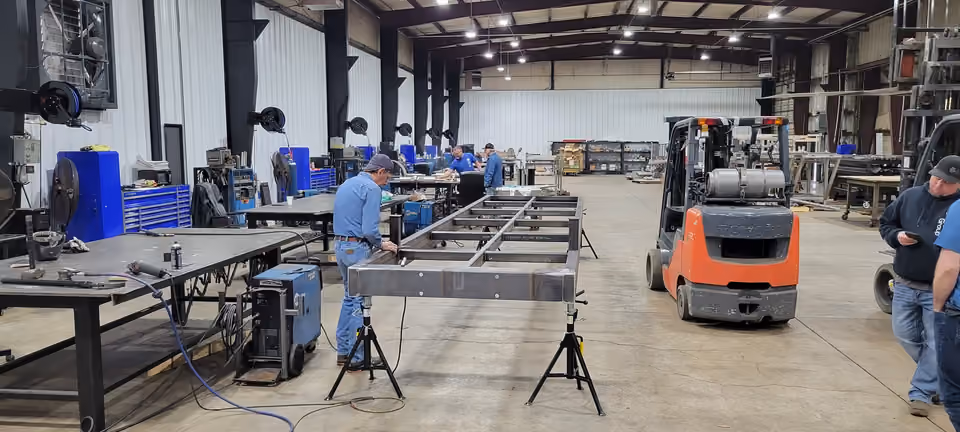

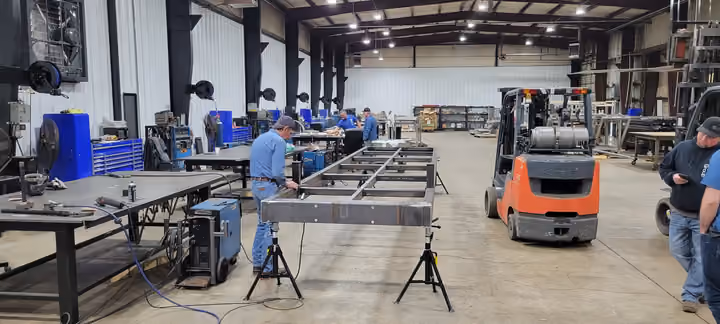

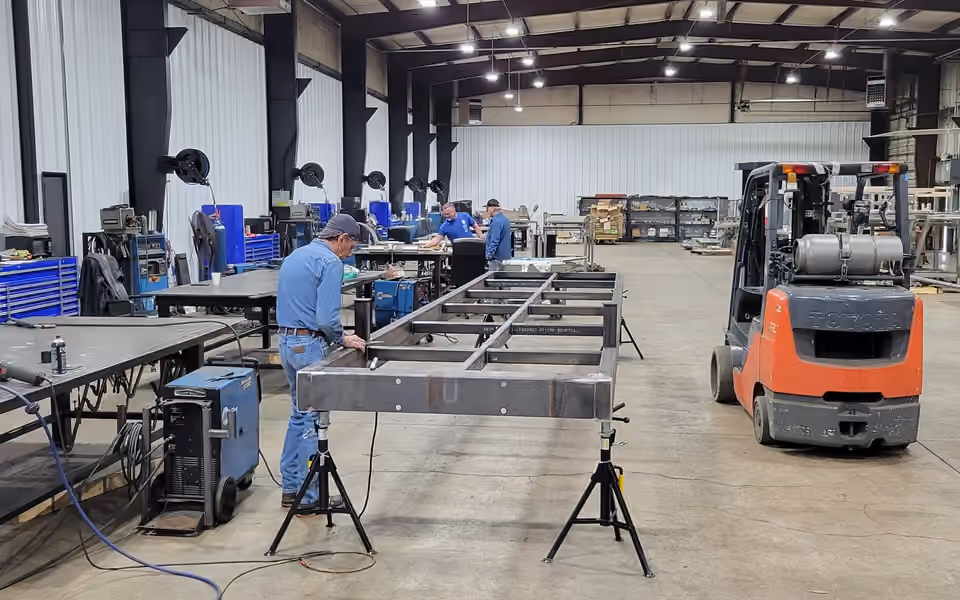

A steel bridge frame on stands in a fabrication shop, with welders working at benches and a forklift alongside.
Truss
The side frames carry the span. Truss height scales with length, from 24 inches on the shortest utility models to 63 inches at 72 feet.
Cross members
Tie the two trusses together and carry the deck between them.
Decking
3 inch by 12 inch Douglas fir on Utility, Pedestrian and assembled kits. Trail bridges are standard with FRP composite decking, which needs no maintenance. Frame-only kits take a deck you supply.
Railing
A 36 inch safety handrail on trail models, a 10 inch bump rail or 36 inch handrail on kits, and ADA-oriented horizontal railing available on pedestrian spans.
Bearing
The span lands on prepared abutments at each end. That is where the load leaves the bridge and enters the ground.
Foundation
Concrete is recommended for many applications and may not always be required. Soil, bank geometry, and the load crossing all decide it.

From prepared site to finished crossing

The set is often a day. The project is about twelve weeks.

Two different questions get asked with the same words. Once the site is prepared and access is in place, setting the bridge is often completed in about a day. Getting to that day is the twelve week part.

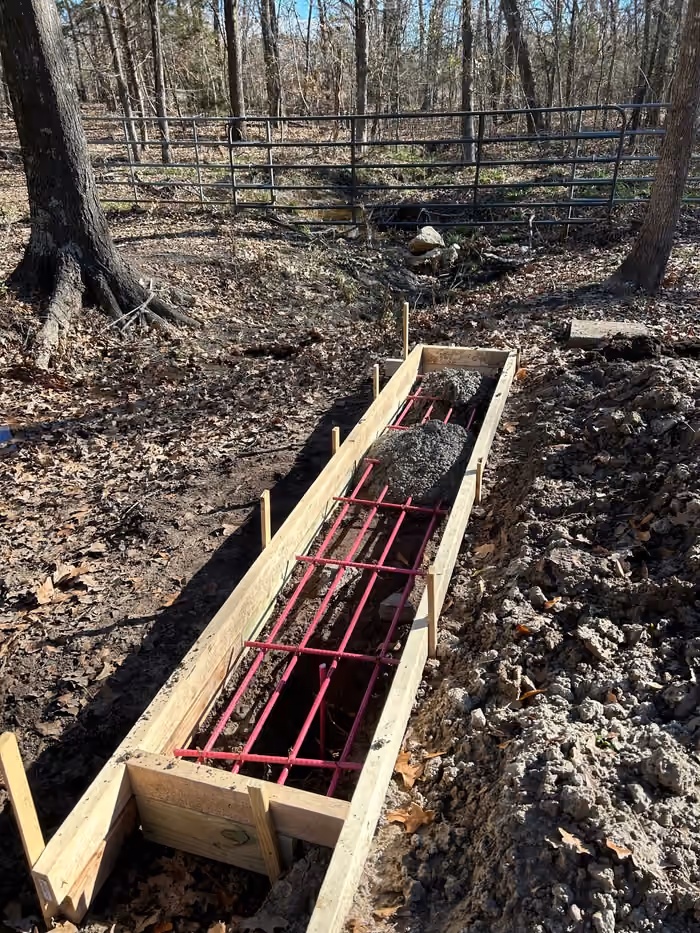

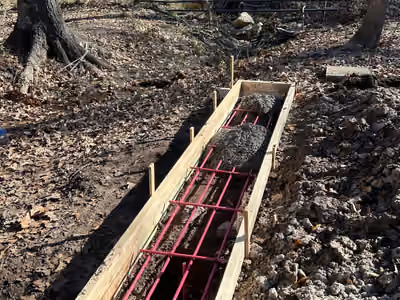

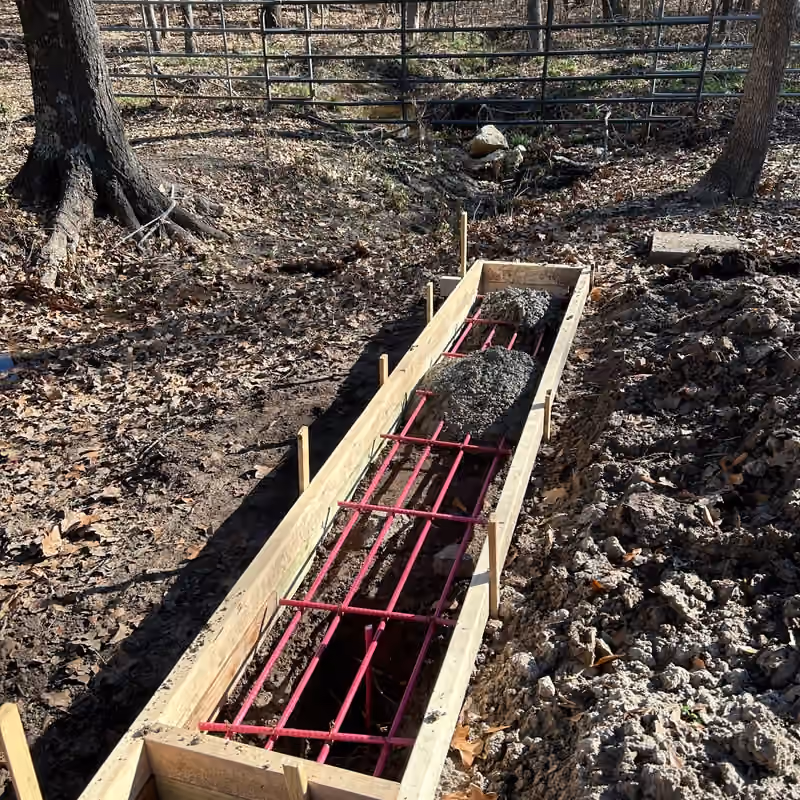

  1. Timber formwork and pink rebar set in an excavated trench for a bridge abutment, in bare winter woodland.
    01

    Site preparation

    Abutments are formed and poured to the engineered design. This is the part that sets the schedule, and it happens before the bridge arrives.

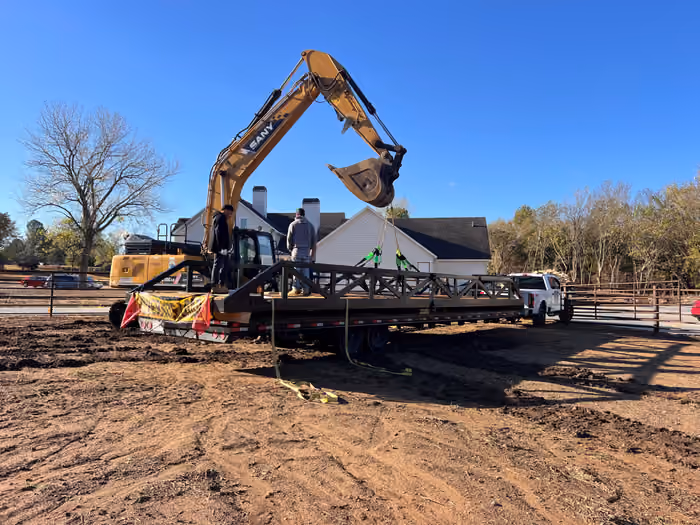

  2. A steel truss bridge strapped to a gooseneck trailer, rigged with slings to an excavator, with two crew members standing on the deck.
    02

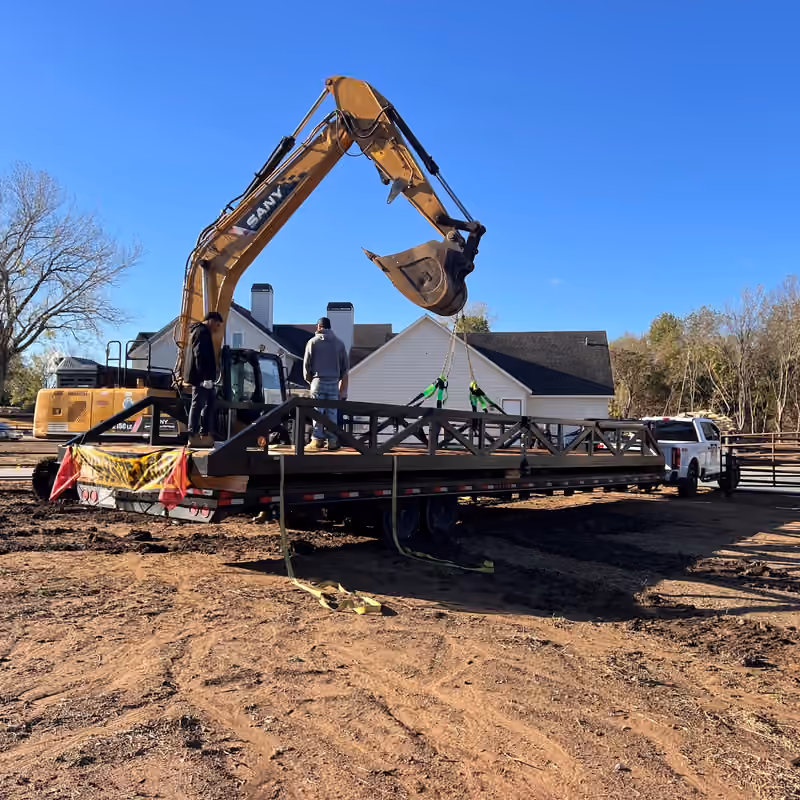

    Delivery and rigging

    The span arrives assembled on a trailer and is rigged with slings. What matters here is whether the truck can reach the site and what equipment is waiting.

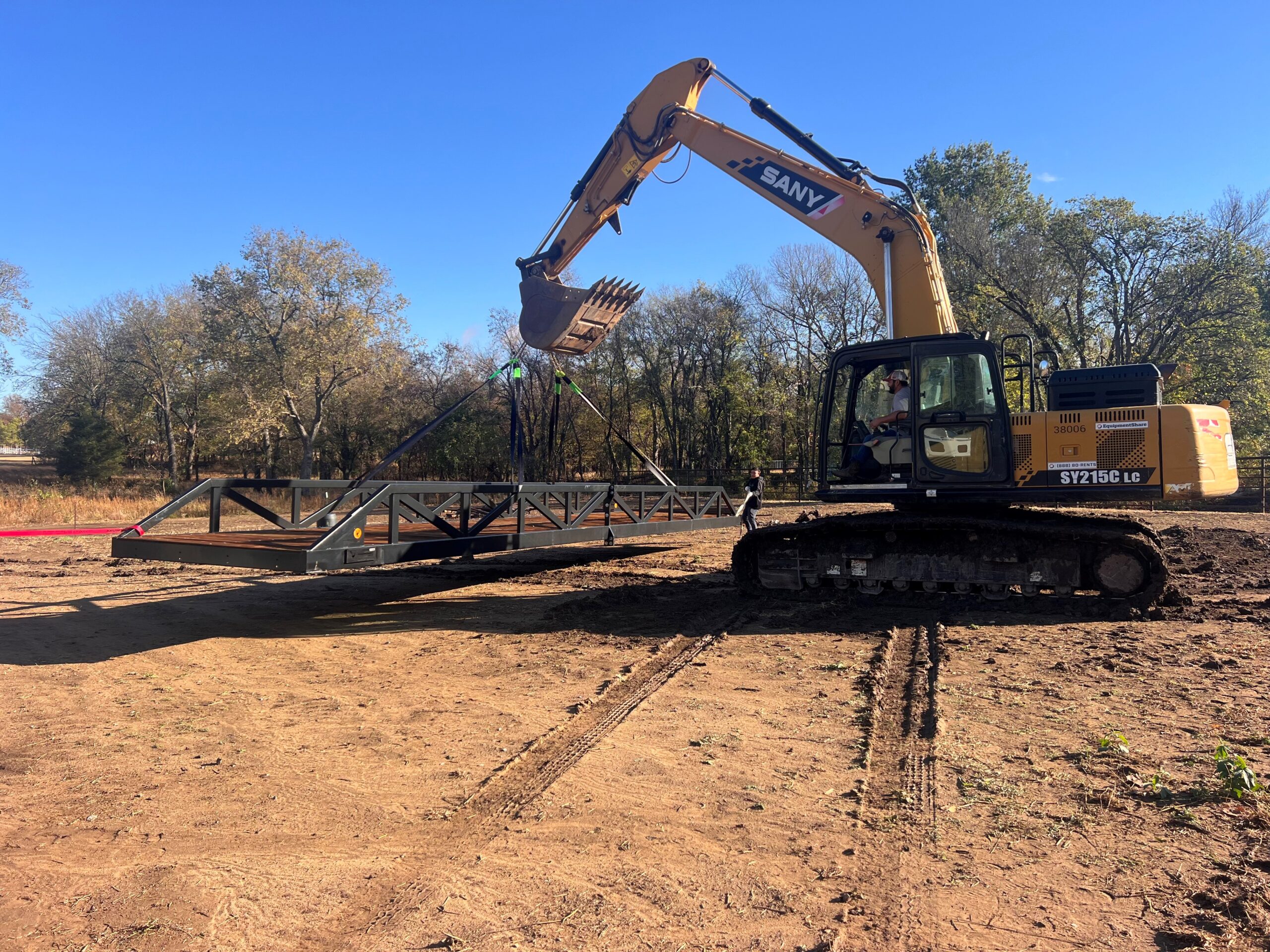

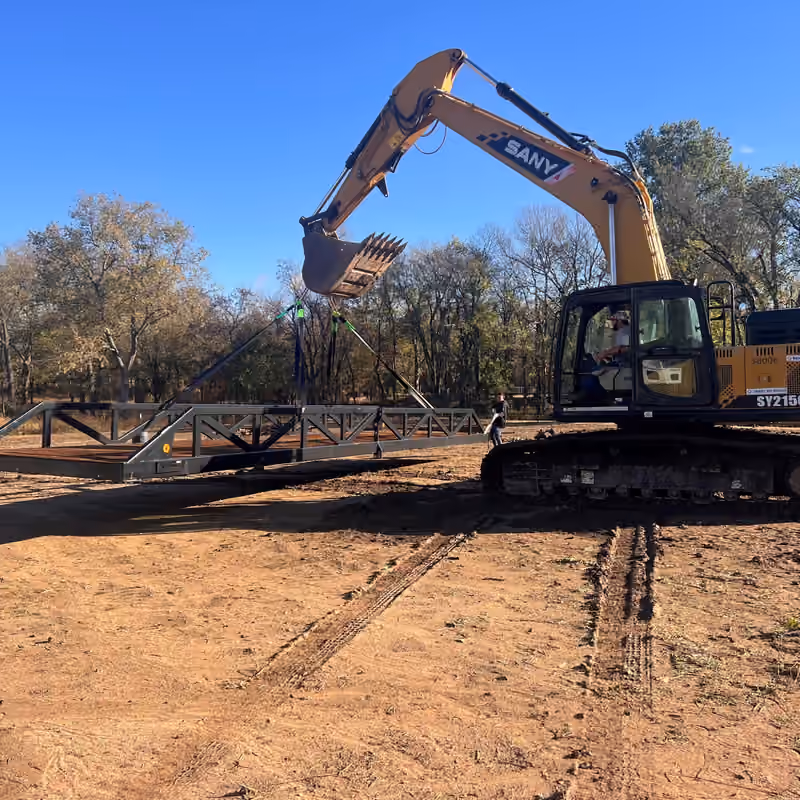

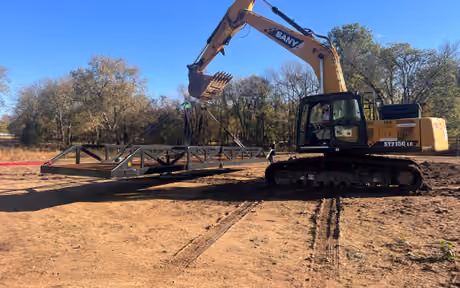

  3. An excavator holding a steel truss bridge suspended on slings above graded ground, ready to place.
    03

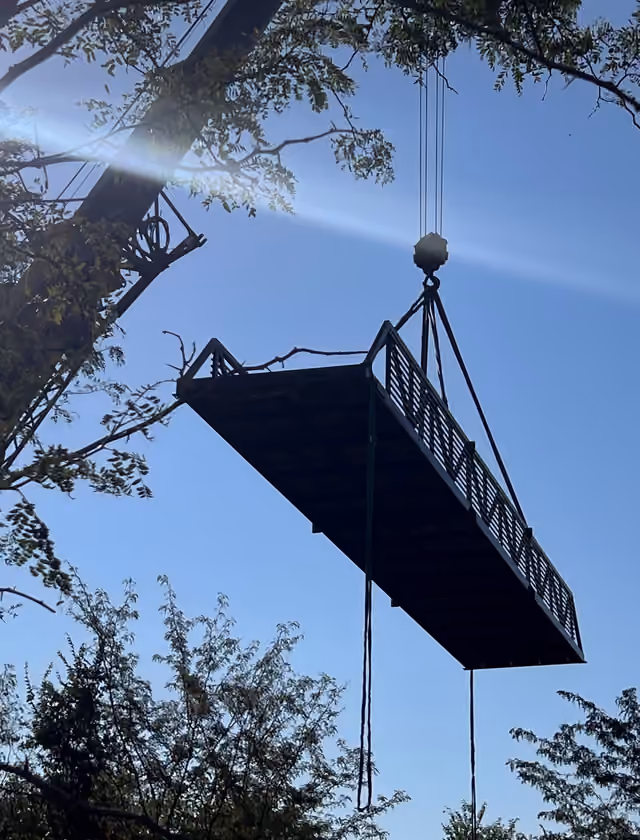

    The set

    The bridge is lifted clear of the trailer and placed on the prepared abutments. Up to 48 feet that is a single pick with no field fabrication. Longer Utility and Pedestrian spans ship on two trucks and are bolted together on site before the set.

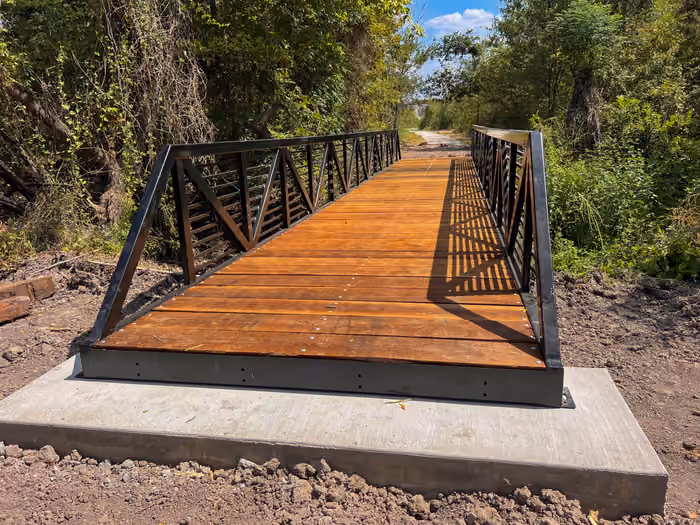

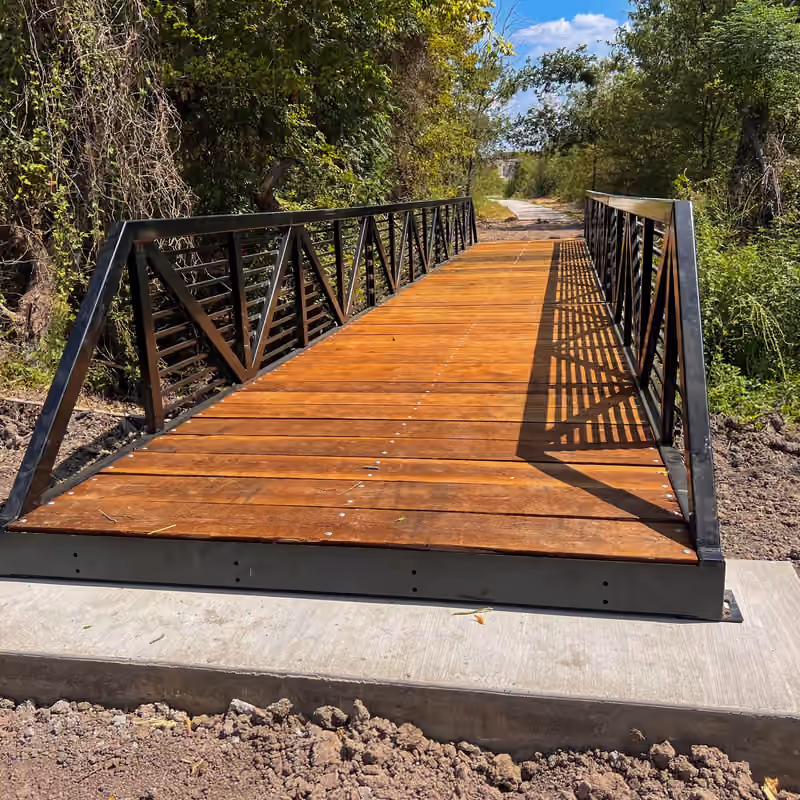

  4. A finished steel trail bridge with timber decking and truss railing, seated on a poured concrete abutment, with a gravel path continuing beyond it.
    04

    Ready for use

    Decking and rails are finished, the approach is graded, and the crossing is walked down with you before anyone leaves.

A typical project

Site evaluation, if needed
1 week
Someone walks the location with you. Not every crossing needs it: many are settled from dimensions and photographs of both banks.
Bridge design
1 to 3 weeks
Engineered for local conditions and loading.
Fabrication
5 to 6 weeks
Built in-house or with certified partners.
Installation
2 to 3 weeks
Coordination, delivery, set, and walkdown.

In service

Carrying the equipment that actually uses them.

All three are Bridge Kits, the bolt-together family, on working crossings.

  • A skid steer loader driving across a steel bridge with timber decking.

    Skid steer

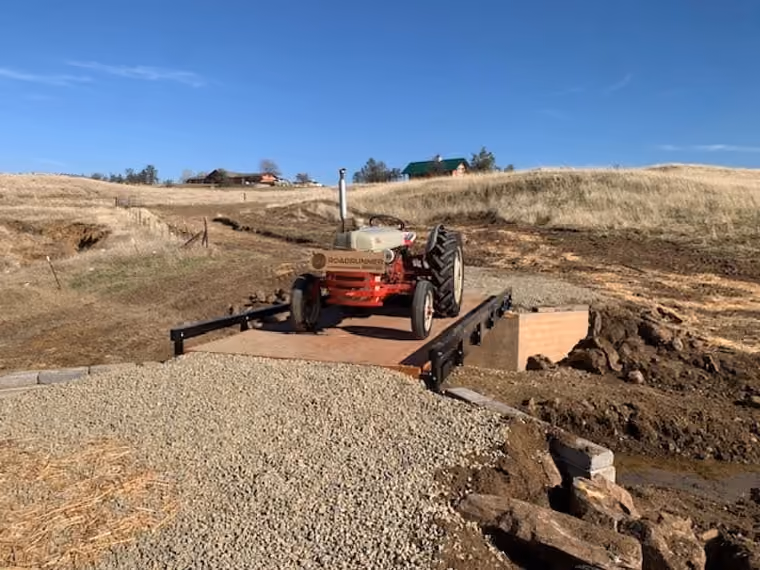

  • A tractor crossing a bolt-together steel bridge kit.

    Tractor

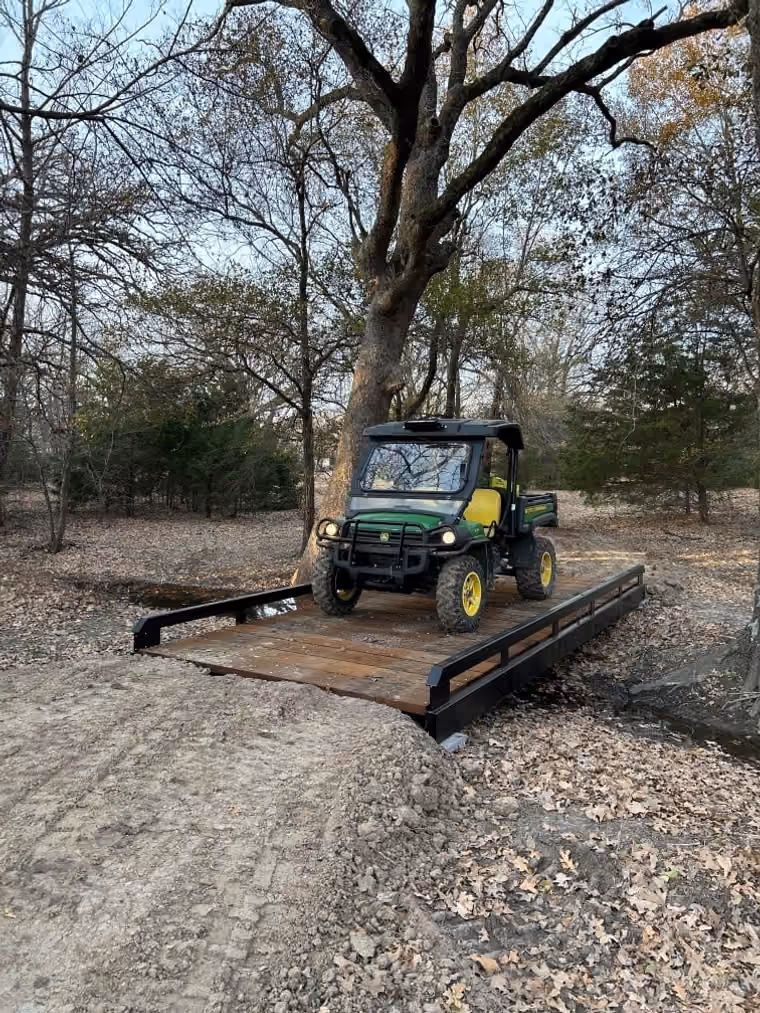

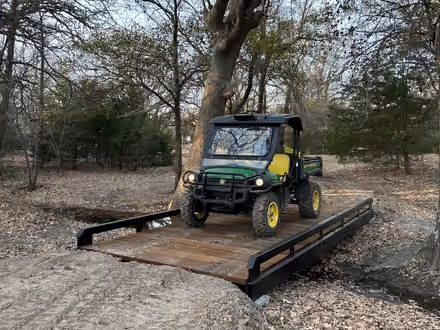

  • A utility vehicle crossing a steel bridge with timber decking.

    Utility vehicle

Each photograph shows one bridge in one configuration. The Kit is published at 4 ton, and which model and configuration each of these is has not been recorded, so none of them is a rating and none establishes what a different bridge will carry on your site. Tell us the heaviest thing that will cross, including anything it tows, and we will confirm it against the engineered configuration.

How it arrives

Assembled on a truck, or flat in a crate.

Site access decides most of it: what a truck can reach, and what is waiting to lift the span off it. The one real choice is whether you bolt the kit together or we do it here before it ships.

  • An excavator carrying an assembled steel truss bridge on slings.

    Fully assembled

    Utility Truss, Pedestrian

    Best for
    Sites a truck and lifting equipment can reach.
    Site access
    Needs room to stage the trailer and position a crane or excavator.
    On site
    A single pick up to 48 ft. Longer spans ship on two trucks and bolt together on site first.

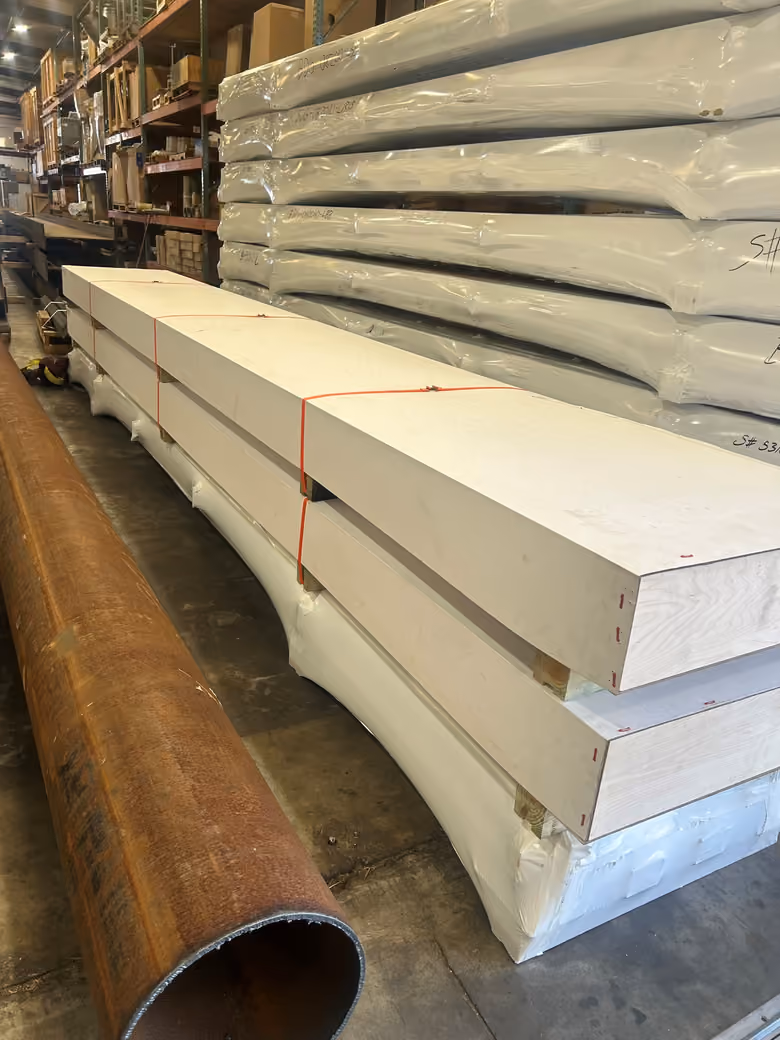

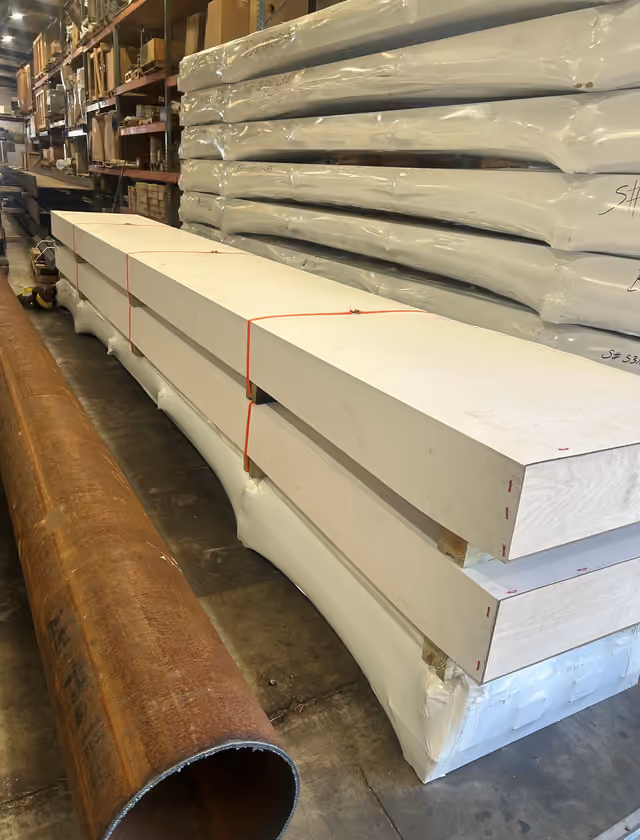

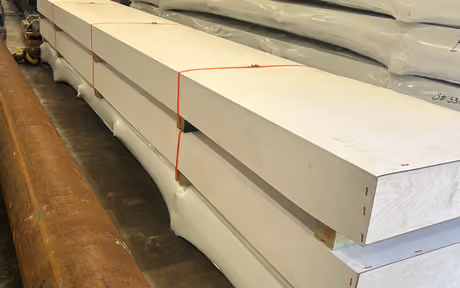

  • A bolt-together bridge kit stacked and banded flat for shipping.

    Bridge kit, shipped flat

    Bridge Kit, Cowboy

    Best for
    Crossings a crane cannot practically reach.
    Site access
    Ships flat. No crane needed at the receiving end.
    On site
    Bolts together on site with hand tools.

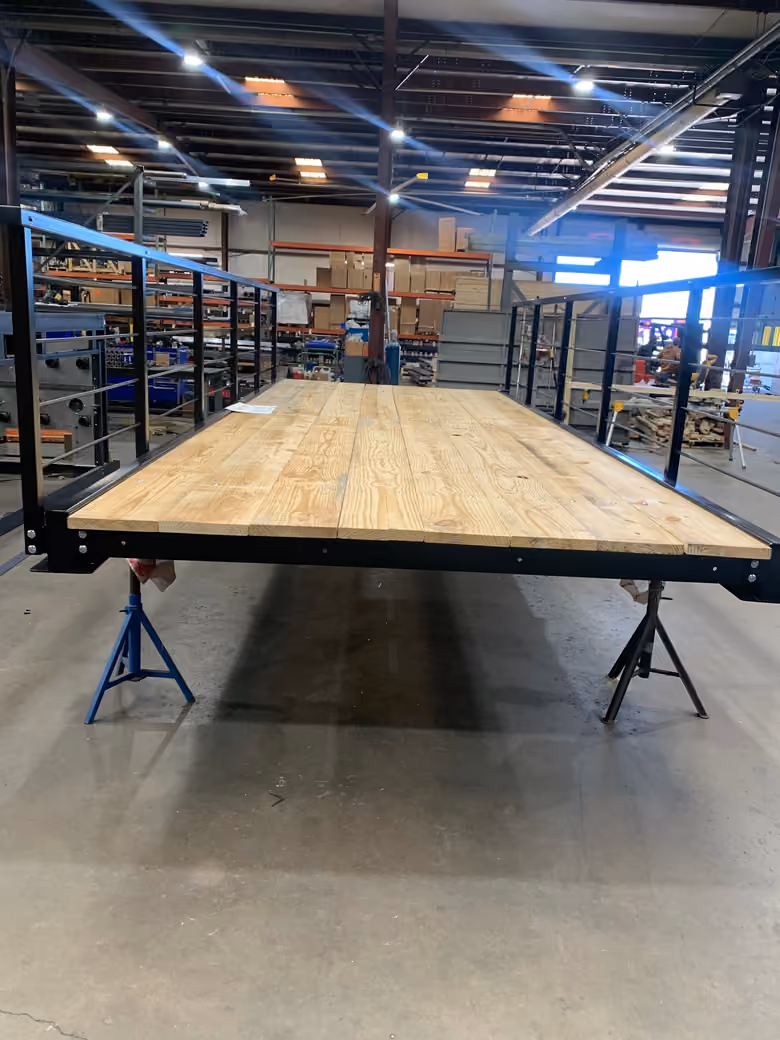

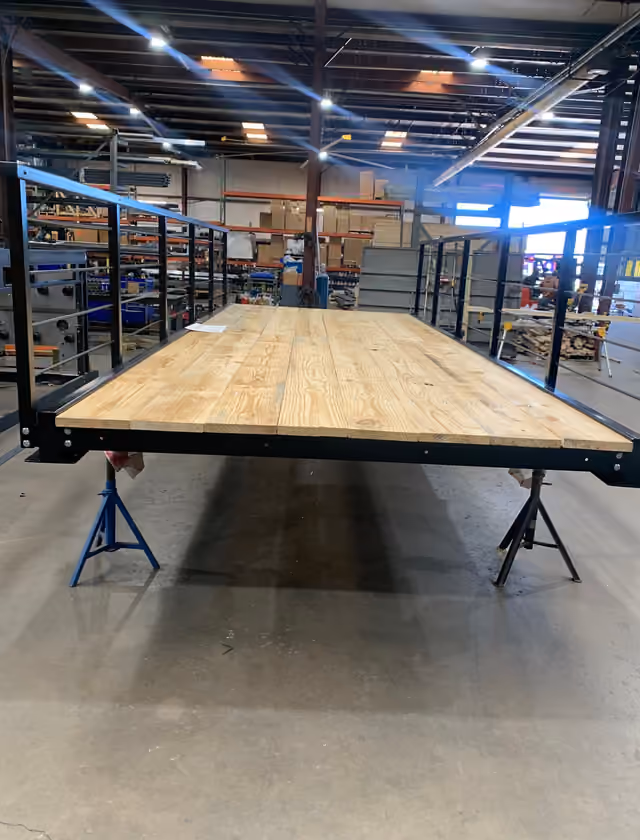

  • An eight by twenty foot bolt-together bridge kit, powder coated with timber decking.

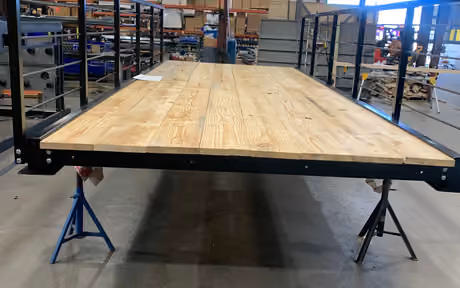

    Kit, assembled before it ships

    Bridge Kit, Cowboy

    Best for
    Buyers who would rather not build it. We bolt it up, deck it and finish it here.
    Site access
    Ships assembled by freight, the same as a Utility span. Something at your end has to lift it off the truck.
    On site
    Nothing to assemble. It is set on the abutments and walked down.

Featured project

Route 66,

Sapulpa, Oklahoma.

Sapulpa is preparing Rock Creek Bridge No. 18 for the Route 66 centennial. The bridge is on the National Register of Historic Places and has stood on the original 1926 alignment for nearly a hundred years. Roadrunner was selected to supply the pedestrian crossing for the park around it: 7 feet wide, 20 feet long.

A small span next to a landmark, which is the whole difficulty. It had to carry the public through the site and stay quiet enough not to argue with the thing people came to see.

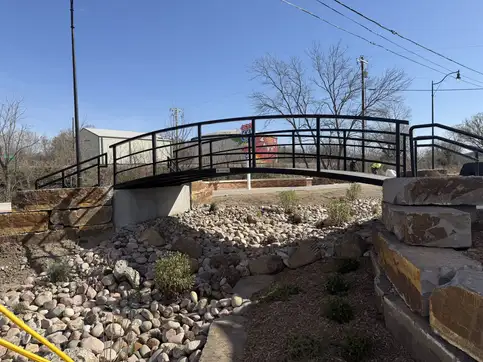

A black steel arched pedestrian bridge with a curved handrail, spanning a dry landscaped creek bed of river rock between stone-block abutments.

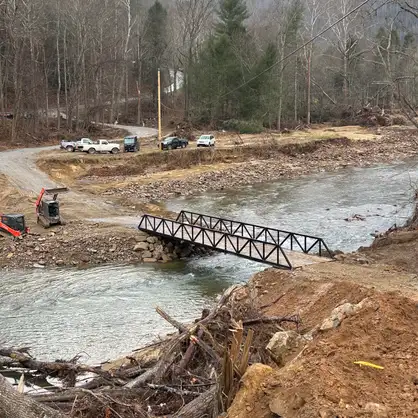

A black steel truss bridge spanning a wide creek in a wooded valley, with pickup trucks parked on the gravel road beyond it and storm debris piled along the near bank.

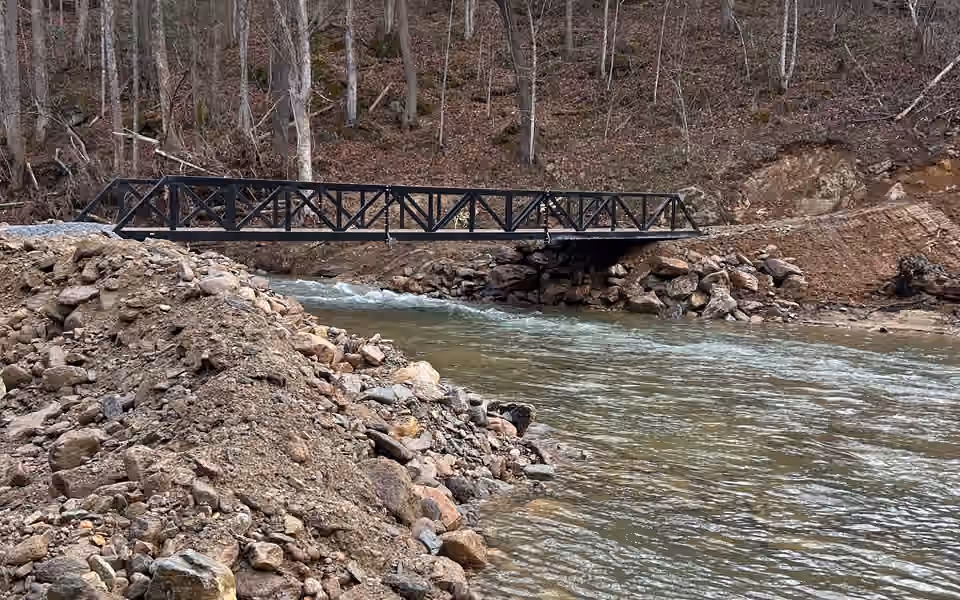

Poga, Tennessee · 2025

Reconnecting Poga after Hurricane Helene

Hurricane Helene flooding took out Poga Bridge 2. The crossing it carried was the way people reached homes, neighbors, supplies and emergency services, and without it a small community was split in two.

Read the project record

Start with the crossing. We will engineer the rest.

  • Know your dimensions

    Work through application, span, width, load, finish, decking, and delivery. What comes back is a quote against that configuration.

    Configure your bridge
  • Not sure what you need

    Send the crossing dimensions, what has to cross it, and photographs of both banks. An engineer will tell you what fits.

    Talk with engineering
  • Budgeting delivery

    Freight depends on crate size, destination, and site access. You get a preliminary range and a manual review, never a number that pretends to be a contract.

    Get a freight estimate
